Pole: The 90's...

Winter 1990

Manager: Tom Fay, population 20

Notable Antarctic aviator (who made his first of many flights to Pole in 1976, and later started Adventure Networks) Giles Kershaw dies in an ultralight accident on the Jones Ice Shelf near Rothera (3/5)

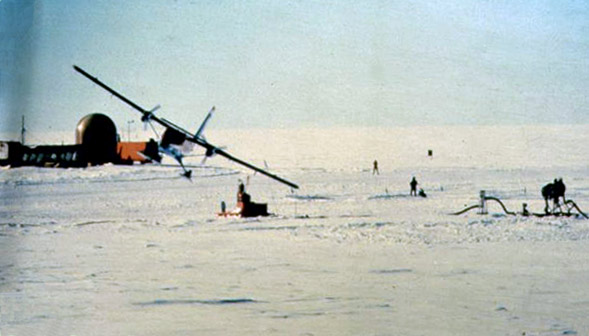

Giles Kershaw buzzing polies
He died as part of an ill-fated documentary filming which was also intended to be covered in National Geographic. During his career Giles made a number of visits to Pole. This photo (of what he did often) was taken during his support of Ran Fiennes' Trans- Globe Expedition which visited Pole in December 1980. A few months before this picture was taken, Giles participated in a medevac near SANAE. (photo courtesy 80-81 w/o Chuck Huss)

Support contractor changes from ITT ANS to ASA, a joint venture of Holmes & Narver (H&N, the first support contractor in the late 60's through 1980) and EG&G (4/1)

Greenhouse experiments underway in former paint/DNF storage hut moved into the dome.

Greenhouse diagram

The small building, also previously used for DNF storage, was gutted, reinsulated and vapor sealed, and equipped with a vestibule. More info, a photo of the interior, and credits are here.

Comms department completes move into new addition.

USAP moves offices, warehouse and CDC to the Antarctic Centre site (September)

free Hagglund rides The old CDC/Navy base site at the airport entrance roundabout was part of this real estate swap with the airport authority and a developer. The old site would be used for air cargo companies; this new facility replaced USAP offices downtown, and provided space for the NZ program. Plans at the time included what would become the Antarctic Centre, later constructed in the foreground of this photo...as well as temporary living quarters for science and contractor personnel...which never happened (Antarctic Journal, December 1990).

Summer 1990-91

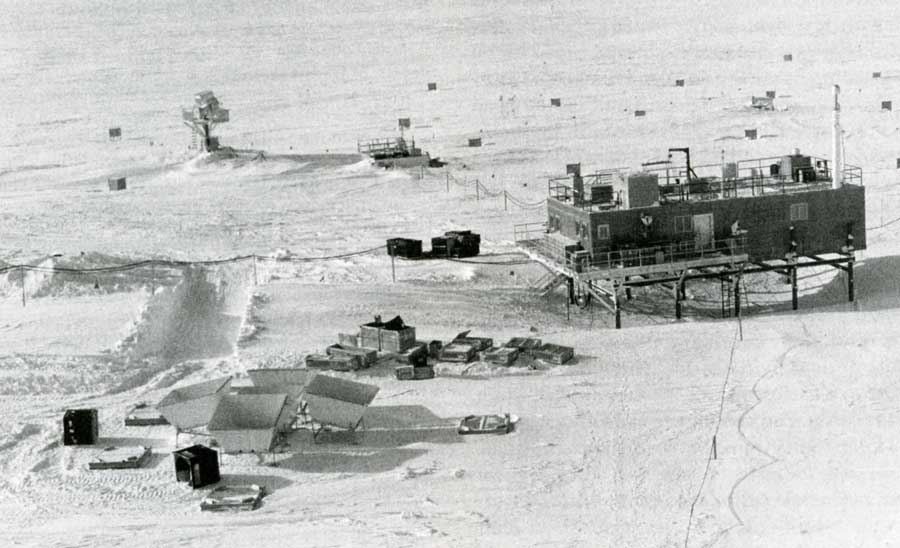

Pomerantz Land (solar-polar) site, CMBR sites are operated again.

Power plant upgrade continues, #3 engine is replaced with a new 3412, one more to go...

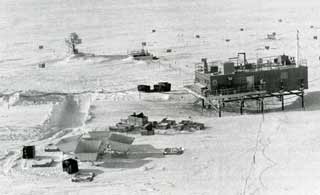

South Pole power plant

Looking into the main part of the power plant from the addition, towards the end of the summer. The original radiator plenums have all been replaced with the new heat exchanger stands, and 2 out of 3 engines are new, but #2 (center engine) is still the original 353...to be changed out during 1991-92 along with the water tank behind it. (Photo by Janet Phillips)

New summer camp emergency galley/lounge is constructed to replace structure damaged by fire the previous season.

Major water system repair effort conducted to fix leaks.

Dome structural and panel repairs are completed.

Five fuel bladders in the fuel arch replaced (with new bladders).

Switch from DFA and JP-4 to a single fuel (JP-8/AN-8) is underway.

Foundation for Carnegie-Mellon CMBR telescope (s) is constructed at CMBR.

Winter 1991

Manager: Dennis O'Neill, population 21

Dump burning is discontinued, recyclables and hazardous waste is collected and saved for retrograde.

Open burning of trash at McM Fortress Rocks Landfill is stopped (2 March) after asbestos discovered on site; "temporary" incinerator installed (in the in the same building which had housed the 1972 incinerator and used for food wastes and landfill operations discontinued--all other wastes were stored for retrograde (the incinerator story).

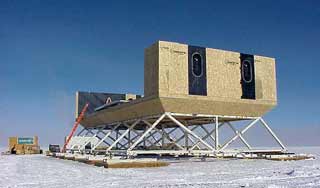

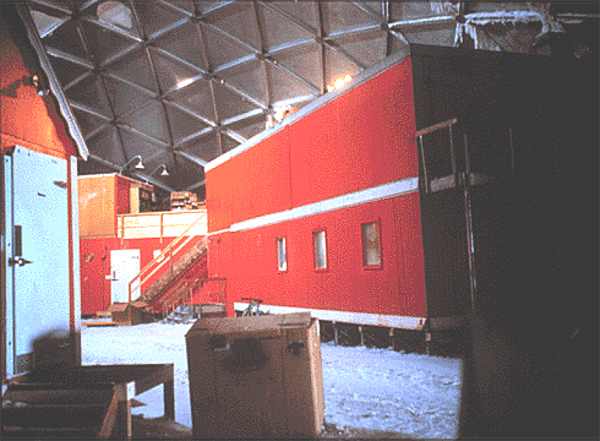

First galley addition constructed, this was the 2-story extension toward the freshie shack, including new counters and a dishwasher.

The dome galley with addition

The galley as it appeared after winter 1991...the extension on the south end toward the freshie shack is visible from the change in the red and white siding. The aluminum porch and landing are in front of the first floor entrance (the wooden stairs in the back- ground are to the roof of the freshie shack). (CARA photo)

Former McM chapel (Quonset hut next to building 155 in use as the temporary chapel between 1978 and 1989) destroyed by fire (May) (chapel information)

CARA organization officially established encompassing future COBRA, AST/RO, SPIREX projects.

Midwinter airdrop includes a bunch of McMurdo mail.

"Madrid" Environmental Protocol adopted by the Antarctic Treaty nations (10/4), ratification would take a few more years.

Summer 1991-92

PICO (Polar ice coring office) shows up and drills 4 820m holes for strings of photo- multiplier tubes, testing for a future SPASE/GASP project to detect neutrinos, this project would later become AMANDA (Antarctic Muon And Neutrino Detector Array...)

Summer camp consists of 10 Jamesways, 2 heads, one galley/lounge. Maximum station population cap was 140, making for crowded mealtimes and bathrooms...

More piping rework in the power plant to improve the glycol system performance.

Construction began on the exhibit portion of the International Antarctic Centre in Christchurch.

construction sign for the International Antarctic Centre
At left is the construction sign for the second of three planned phases of this project, which was being developed by the Christchurch Airport Company. This contract was awarded in November 1991. The first phase, the offices, warehouse, and CDC, had been occupied in September of 1990. The straight and curved lines of columns were intended by the architect to extend the lines of the Phase 1 structures and reference the South Pole and an east-west meridian. The exhibit hall was officially opened on 31 August 1992. Phase 3, planned temporary housing, was never constructed (photo from Frederick McDougall).

Third 3412 (engine #2) is installed to complete power plant generator upgrade project, work slowed by another asbestos survey, this time some is found in the exhaust stack insulation.

Potable water tank in power plant is replaced with larger capacity stainless steel tank.

Remaining bladders in the fuel arch are replaced.

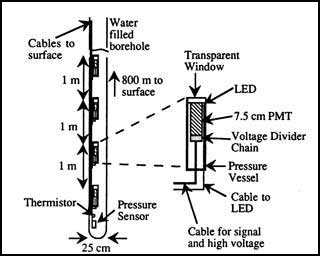

First preliminary testing conducted using a string of photomultiplier tubes...

first test photomultiplier tube string

At left, a schematic of the drill string, which was intended more to study the Cerenkov light transmission properties in ice than to actually collect data on particle-generating events. The project also confirmed the performance of PMTs to be able to detect Cerenkov light. The test string was also monitored in 1992-93, and the rest is history, as IceCube installation was completed in 2010-11. More information, documentation and credits.

"White Dish" CMBR telescope, predecessor to Python etc., erected at CMBR site.

USGS installs new GPS station on roof of skylab and discontinues doppler satellite tracking program (December)

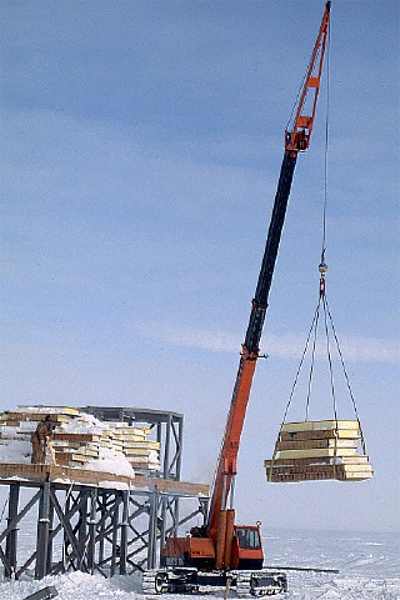

AST/RO (Antarctic Submillimeter Telescope/Remote Observatory) building foundation and structural steel erected, to be the first structure in the new dark sector.

AST/RO foundation structure

The AST/RO structure after the first year of construction; the building panels were staged on top of the platform for the winter. This was the first use of those foam insulated wall panels that would later be used for everything else including the new station. (photo by Galen Rowell)

Where'd this stuff come from? The first summer airdrop since the pre-Herc era dropped some of the larger components for this structure.

New seismo vault occupied, sponsored by IRIS (Incorporated Research Institute for Seismology) but still operated by USGS; Drum-type analog seismographs in the science building replaced with digital models, earthquakes will never look the same.

Norwegian glaciologist Monica Kristensen and assistant show up (by plane, as an NSF-sanctioned project) proposing to bring ground-penetrating radar to look for Amundsen's tent, their attempt to do that in 1993-94 proved fatal...

tent set up at the location of Amundsen's tent The venture was part of a planned 3-year Norwegian/UK/Swedish glaciology expedition to study climate change. The team traveled to the ice on the MV Aurora (which Monica had previously purchased for her unsuccessful 1986-87 NGA South Pole trip) and set up a 5-hut base (Blaenga) at 77.5ºS-34.2ºW. While other scientific studies were underway elsewhere, Monica's team reached Pole on 16 February using their Twin Otter. They set up a pyramid tent above the presumed location of Amundsen's tent, using data from Scott's and Amundsen's records and GPS, but planned GPR studies were not conducted. The tent project was sponsored in part by STATOIL and the Lillehammer Olympic Organizing Committee, as the plan was to recover the tent for display at the 1994 Winter Olympics in Lillehammer. When the team left, only the Norwegian flag was left for the winter.

Japanese adventurer Shinji Kazama reaches Pole (3 January) on a specially modified Yamaha motorcycle.

Shinji Kazama at Pole

The trip from PH took 24 days. Shinji was supported by a snowmobile which provided occasional assistance over rough areas. More information...

Construction starts on Pegasus blue ice runway near McM.

Crary Science and Engineering Center (CSEC) dedicated at McM (11/5).

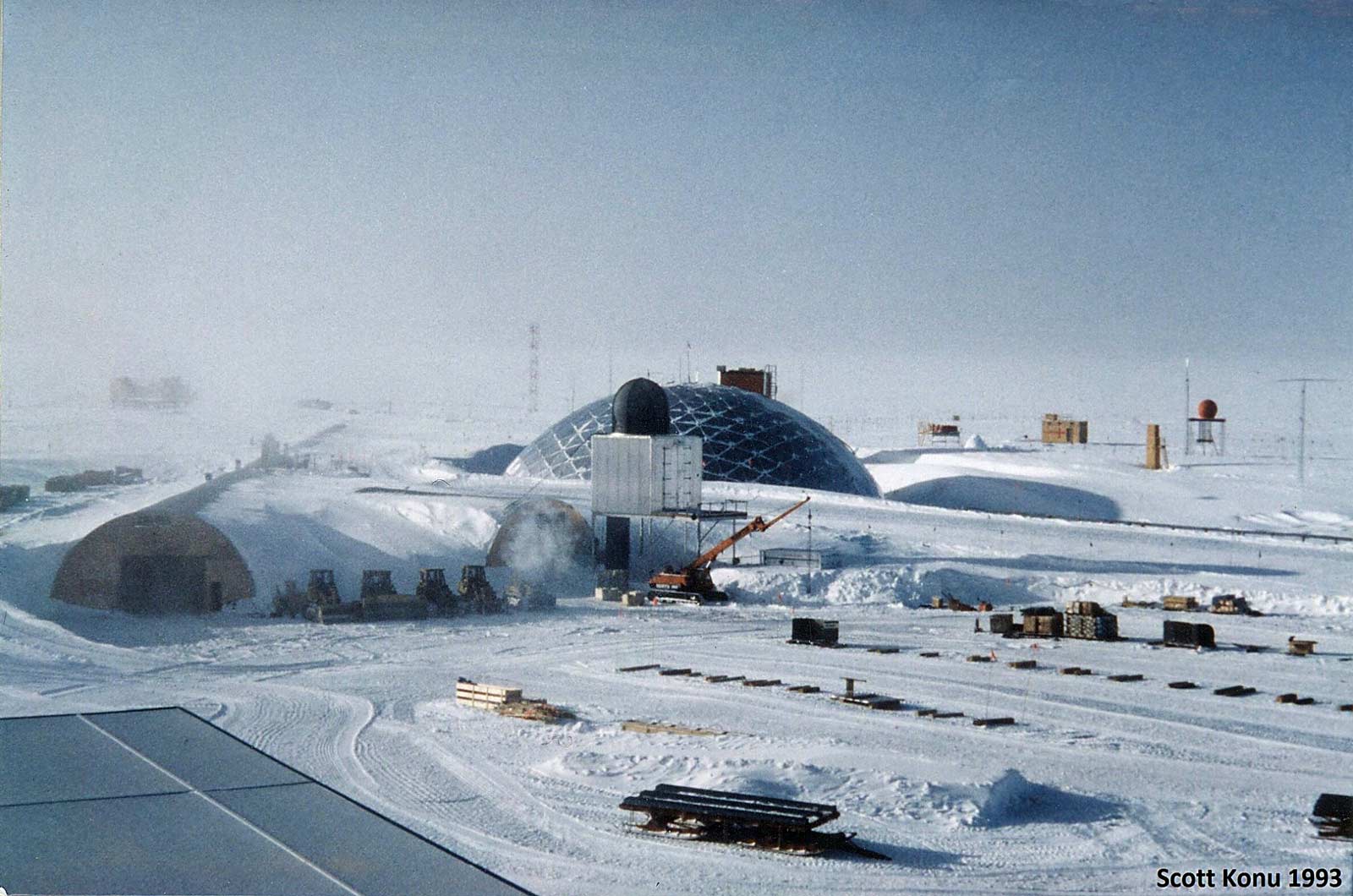

Winter 1992

Manager: Gary Freeman, population 22

New greenhouse equipment and lighting (prefabbed in McMurdo by Phil Sadler and volunteers); managed at Pole by Kitt Hughes (here is the environmental impact statement for this effort...this era was when NSF when writing these up for many Antarctic projects.

International Antarctic Centre exhibit hall dedicated (31 August) by British botanist David Bellamy shattering an artificial ice wall with an ice axe. It was opened to the public the next day (earlier information about the project).

McM "interim" incinerator constructed (??)

Summer 1992-93

Summer population cap 125; much more supportable than the previous year's 140

AST/RO building construction continues, structure enclosed and interior work underway.

CARA tests prototypes for AST/RO and COBRA (COsmic Background Radiation anisotropy) experiments.

Current array of long-term snow stakes installed using GPS survey techniques--a total of 240 poles in 6 20km strings 60° apart. The stakes were installed so the original height of each pole above the snow surface was exactly 6'. They are monitored yearly.

Compressor/vaporizer system installed to enable use of liquid helium instead of gas bottles for weather balloon launches.

Shell of Elevated Dorm (blue building) completed.

Wet silencers installed on generators for additional heat recovery for Rodriguez well.

Wind profiler radars (five 2x2m antennas) set up on the surface southeast of CAF.

wind profiler at CAF This view from the met tower shows the five new 2m x 2m square antennas in scooplike shields next to CAF (presu- mably the trench is unrelated). Additionally there were four acoustic sources, and as part of this project, an array of four automated weather stations (AWS) were in- stalled at 89ºS, 90 degrees apart. The 915-mhz radar detected the movement of moisture, hence wind, up to 2km above the surface. The late Kathie Sharp (later Kathie Hill Baker) was the winterover who monitored this project. This photo also gives a good view of the SPASE-1 boxes and the GASP telescope (Jesse Leech, Antarctic Journal, 1994 review issue)

CRREL makes first Rodriguez well installation at the domed station (a "sewer bulb" in reverse, hot water is circulated to melt more, when the bulb gets developed enough, some of the water can be used by the station). Water treatment system is installed too, but all this is finished too late to permit winter use--or, as has been said, the plan was to allow 1 year for water circulation for bulb creation (the well idea was originally developed by Army engineer Raul Rodriguez, for Camp Century, Greenland in 1960-61; the first rodwell at Pole was tested successfully in 1972-73). Here's the inside story on the Pole rodwells including video (!)

New GCA (ground control approach/air traffic control system) installed.

NGA (Non Government Activity) events--Five Norwegians, Ralph Høibakk, Herman Mehren, Sjur Mørdre, Simen Mørdre and Hallgrim Ødergård, are the first to use the now well-traveled route from Berkner Island to Pole. Norwegian Earling Kagge is the first unsupported skier from Berkner Island, in 50 days (1/7) "Antarctic Women's Expedition" arrives also, but doesn't continue to McM due to time constraints.

McM Pegasus blue ice runway certified for use by wheeled C-130's. Originally 6000 feet long and 300 feet wide...its first LC-130 takeoff using wheels was on 8 February.

The DC Appeals Court rules that the National Environmental Policy Act (NEPA) applies to Antarctica (29 January), the decision was not appealed, so the "interim" incinerator at McM was shut down (22 March), and NSF discontinued plans for the permanent replacement.

Winter 1993

Manager: Stan Wisneski, population 28 (!) a new record

New stove exhaust hood system installed in the galley.

Fire escapes and emergency exit hatches installed on dome berthing rooms (by winter construction crew--the first since the dome was built).

Construction crew finishes out interior of Elevated Dorm

31-gallon oil pans are installed on Caterpillar 3412 Genset numbers two and three. This allows an extra two hundred and fifty hours between services.

Electrical code violations corrected in the Greenhouse. Completion of these repairs allowed use of this facility to continue.

The main sewer outfall elevation dropped approximately six inches breaking heat tape and disabling the line. After two months of attempts to repair the line, it still did not function. Backup line used until a new line could be run the following summer.

All use of the dump at Pole discontinued in accordance with Madrid Protocol; all waste saved for retrograde.

Serious McMurdo windstorm blows down the cross atop Observation Hill...it was reinstalled the following summer (see below).

Summer 1993-94

SPIREX (South Pole Infrared Explorer) telescope installed temporarily on roof of AST/RO building.

CMBR telescope PYTHON erected between AST/RO and MAPO building sites.

CARA/AMANDA building construction started, building framed and enclosed, partially in use by AMANDA group.

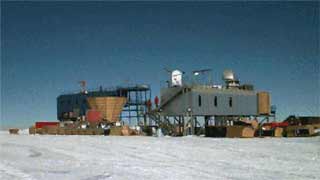

new CARA/AMANDA building This photo, looking northwest from the AST/RO building roof in January 1994, shows the newly enclosed CARA/ AMANDA building (as yet unnamed anything else) still under construction. It is missing the SPIREX platform, which would be constructed on the near end of the structure a year later. In the foreground is the CMBR telescope PYTHON, in the left background is the PICO site where the first permanent AMANDA holes are being drilled. The dome is directly behind you across the skiway. (CARA photo)

First permanent drilling/construction for AMANDA, four strings are installed to ~1km deep and made operational.

Monica Kristensen tries for Pole again to search for Amundsen's tent and flag to take back to Norway for the Winter Olympics. Seriously! During the traverse to Pole, fellow Norwegian Jostein Helgested is killed in a 130' crevasse, The USAP/NZ SAR team led by Steve Dunbar goes in via Pole and lands at the site in a Twin Otter to rescue the rest of the NGA expedition from a serious crevasse field in the Shackleton Range. Here is the full story from the June 1994 Antarctic Journal, and also from USA Today.

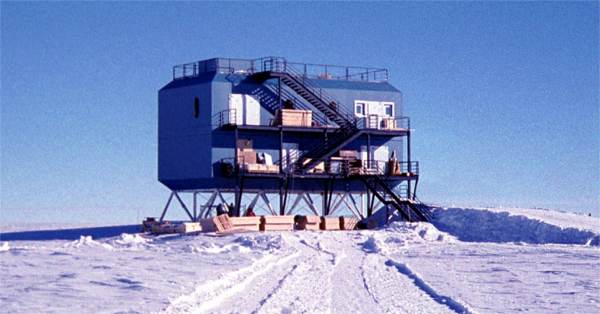

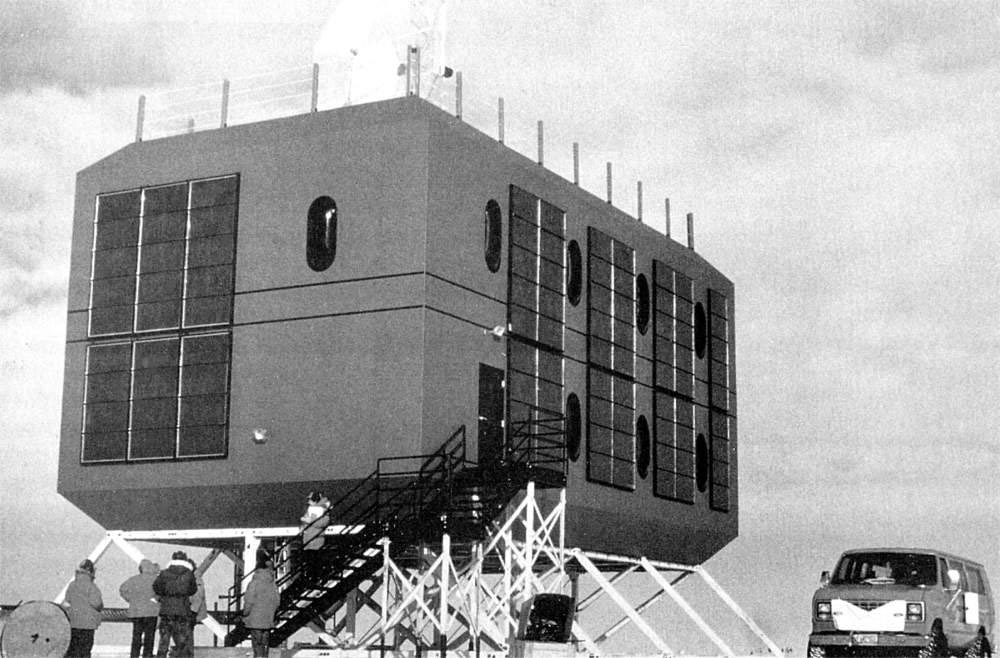

Elevated dorm completed and occupied (December)

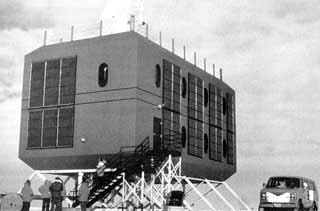

brand new elevated dorm The 3000-square-foot structure was originally configured to house 19 people, with 2-1/2 baths, galley, lounge, and laundry. The solar panel heating system cut fuel usage from 56 gallons to 12 gallons during the first week of operation. It was designed for sum- mer berthing and winter use as the emergency camp (Antarctic Journal (NSF photo), 1994 review issue). Three more of these berthing structures had been pro- cured, but they never were used for berthing. So then...

4.5m antenna installed on elevated dorm for GOES-2 "broadband" access and 2 small antennas were installed to hit LES-9...

new GOES-2 antenna on the roof of the elevated dorm

An aerial view looking toward the dome, with the new elevated dorm in the foreground and the GOES dish on its roof. This picture was probably taken in about 1995-96. (NASA photo).

This provided some of the first real-time internet connections

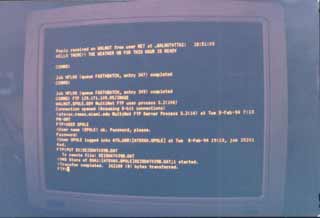

screenshot of first internet activity Here is the screen shot of the first true Internet connection from South Pole to the outside world, via LES-9, on 8 February 1994. Prior to this connection, data was sent over a serial modem, in much the same way teletype messages were sent over HF to McMurdo in the old days. With the old, non-internet connection, all data and email traffic went through the comms operator who batched things up, (after reading the mail for the juicy bits) and manually transferred the data up north. (More information, credits, and larger screen shots...)

Major galley addition started on "window" side as well as on the end towards the main entrance arch.

Rodriguez well certified as a potable water source

Movable 10,000 gal steel fuel tanks on skis show up for storage of emergency fuel, replacing bladders on the surface

Scott's memorial cross reinstalled on Observation Hill (23 January)

reinstalling the Ob Hill cross The cross was originally erected on 22 January 1913 by surviving members of Scott's Terra Nova expedition...it took them 2 days to carry the cross up the hill. More recently...members of the McM and Scott Base communities carried the cross up the hill. After it was installed, a small service by the local clergy closed the ceremony; it was recorded for NZ television (photo by Robert Holmes).

McM Pegasus runway in service for C-141's in February.

Winter 1994

Manager: Janet Phillips, population 27

SPIREX catches Shoemaker-Levy comet collision with Jupiter, watched by some of the first CARA w/o's with data sent back via the new satellite links

Galley interior completed

view of dome buildings from the top of the dome This 1998 view from the top of the dome shows the more recent additions to the galley, including the dining area expansion and interior stairs on the east side, they lead up to the bar or what is now more commonly known as the upper galley. Also there is a new pantry and upper lounge area on the north end. The large white area in the center of the picture is the roof of the greenhouse, which was built in 1994-95 on the roof of the Annex...directly above the room I occupied in 1977. Hmm, I heard the roof would sometimes leak...the 1989 addition to the east end of comms can also be seen. To the left of the science building is the electrical substation which was built in 1994-95. This picture also shows the "fire escape" hatches which were installed on the berthing rooms in 1993. (photo by Robert Schwarz)

Serious power outage in March due to frozen glycol in the radiators; summer camp generator fired up to backfeed station after 50 dark minutes, more than 3 hours elapse before full power is restored.

Before water consumption began, the Rodriguez water well heat tape catches on fire in the hole and the system freezes up, one day after the power outage; snow melter ops continue.

CARA building interior construction continues in winter.

First videoconference from Pole (9/13) using CuSeeMe software and the LES-9 satellite (Michael Hancock talks to CARA in Wisconsin from the new CARA building)

Janet Phillips was first female Pole manager; after McM winfly all 3 US stations have female sm's (Ann Peoples at Palmer, Karen Schwall at McMurdo). Here's an article Janet wrote about this for her local paper, the Jemez [Springs, NM] Thunder, for Women's History Month.

Summer 1994-95

CARA building finished and dedicated as Martin A. Pomerantz Observatory (MAPO)

Marty Pomerantz with the MAPO plaque

At left is John Lynch with Dr. Pomerantz. They are holding the plaque which would be installed inside the building to commemorate the dedication. This would be Marty's last trip to the ice (more photos and the Antarctic Journal article about the dedication). Behind them to the right of MAPO is the early construction of the SPIREX platform. And perhaps coincidentally or perhaps not...

...the Pomerantz Land solar observatory site operated for the last time.

CRREL comes back to rework the water well; new hole drilled (water in bulb still liquid after 9 months), water again officially declared potable (they also harvest micro- meteorites from the water bulb).

AST/RO telescope installed, annex added to AST/RO building for liquid helium storage.

SPIREX platform constructed on MAPO, telescope moved from AST/RO building

the dark side
The dark sector as it appeared in January 1995 as you approach from the dome. The AST/RO telescope has just been installed on the right side of the roof of the AST/RO building in the fore- ground. Behind the CMBR telescope, the SPIREX platform is under construction on the end of MAPO (Photo by April Lloyd).

New Gorman-Rupp pump and aircraft refueling station set up.

Permanent greenhouse constructed on top of annex.

New electrical substation building constructed in the dome (next to the main entrance, north of the science building) to replace all of the manual transfer switches in the power plant arch.

First live TV broadcast, a NASA QUEST program titled "Spaceship South Pole" (1/11) provided interactive contacts between station residents and students.

Retrograde of backlog of solid waste since 1991 (300+ tons) completed.

[?]Met tower in clean air sector relocated (to make way for the new NOAA building?) (? Or did this happen early 95-96 )

SPASE-II construction started in dark sector 1/4 mile SW of MAPO

Winter 1995

Manager, John Parlin, population 28

First greenhouse operations limited by electric power shortages.

First AST/RO observations.

Summer 1995-96

SPASE-2 array construction starts 1/2 mile south of MAPO.

CRREL shows up and tests their new utilidor tunneling machine (at one time there had been plans for a tunnel all the way to the dark sector, under the skiway...) (my coverage of the tunneling projects).

New 2-story building for NOAA under construction 500' east of CAF which it will replace.

4 more AMANDA holes, these 2-2.2 km deep "AMANDA-B" drilled and put in operation.

U.S. government shutdowns (14-19 November and 16 December-6 January) force contingency planning to reduce operations to "maintenance mode"--which would have reduced the 1996 w/o group to about 10 people. Fortunately the issue was resolved.

Summer visitors include...

Winter 1996

Manager: Tim Coffey, population 26

No midwinter airdrop; discontinued due to email, supply system improvements, greenhouses, and budgets...

Environmental protocol ratified by Congress, final "official" implementation would take a bit longer yet.

First use of C-141 aircraft (instead of LC-130s) for WINFLY flights to McMurdo

Summer 1996-97

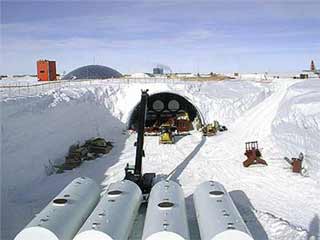

CRREL returns with tunneling machine, digs 400' x 7' wide x 10' high snow tunnel branch off the utilidor for gravity sewer outfall.

Lake Patterson ahead

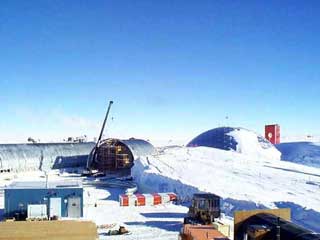

The completed utilidor tunnel with the sewer outfall piping in service. The elevated station uses a similar tunnel system for water and sewage; the waste water is dumped into played-out Rod- riguez well bulbs. (1999 photo by Joel Michalski)

Here is more than you ever wanted to know about the tunnels...

SPASE-2 finished along with intermingled VULCAN (Cerenkov detector) array, AMANDA construction continues with 6 more 2 km strings installed finishing AMANDA-B.

Viper steel structure for the instrument and its control room erected west of MAPO

VIPER structure

The Viper structure under construction in 1996-97. In this view looking northeast, the steel support structure is being erected behind the control room which has yet to receive its blue siding panels. This photo was taken by Todd Cardiff, one of the ironworkers who was putting this puzzle together next to MAPO.

AASTO (Automated Astrophysical Site-Testing Observatory) installed

prototype super-AGO module This structure was a prototype "super-AGO" installed SE of the AST/RO building, soon the web cam would come too, courtesy of JACARA (Joint Australian Centre for Astrophysical Research in Antarctica). Also involved were Jack Doolittle, 1977 Siple w/o, more recently the AGO guy, and fellow Stanford OAE Ev Paschal who was one of the first 4 Siple w/o's in 1973. The project had problems with the propane generators the first few years and was never relocated to Dome C as had been considered, but the testing here was used to develop the units later set up at Dome C and Dome A. The photo is by Michael Burton, from the paper "The history of astrophysics in Antarctica".

New "Balloon Inflation Facility" (BIF) occupied...

new BIF

Before BIT could be torn down, a replacement balloon inflation facility (BIF) had to be completed...here's a construction photo (Chris Rock) is to be credited for this and the next 5 ASA photos...

(more photos of the BIF and original cryo construction).

Other replacement structures....

new cryo

...the new helium storage buildings, one of which is shown here under construction. Some of the liquid helium would also be used for balloons.

...and the new cargo building.

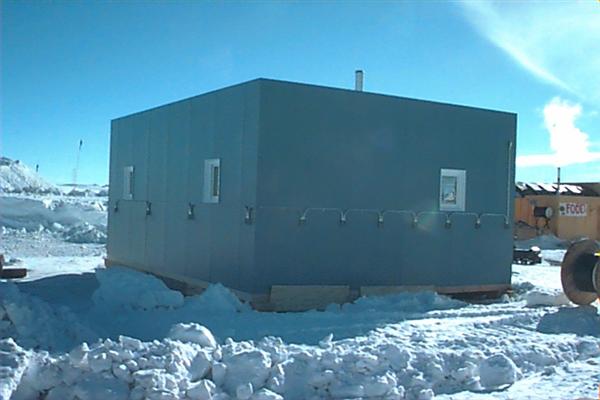

new cargo building

the new cargo building...

The new helium and cargo buildings are occupied...

the new BIT and cargo buildings in use

as seen here from the top of the dome...from the left is the BIF (balloon inflation facility), helium storage, and cargo office. Notice the naked end of the helium arch.

as demolition of the 1975 station begins on schedule to make way for the next one: the Balloon Inflation Tower goes away, followed not long afterward by the helium arch.

demolition of the dome's balloon inflation tower

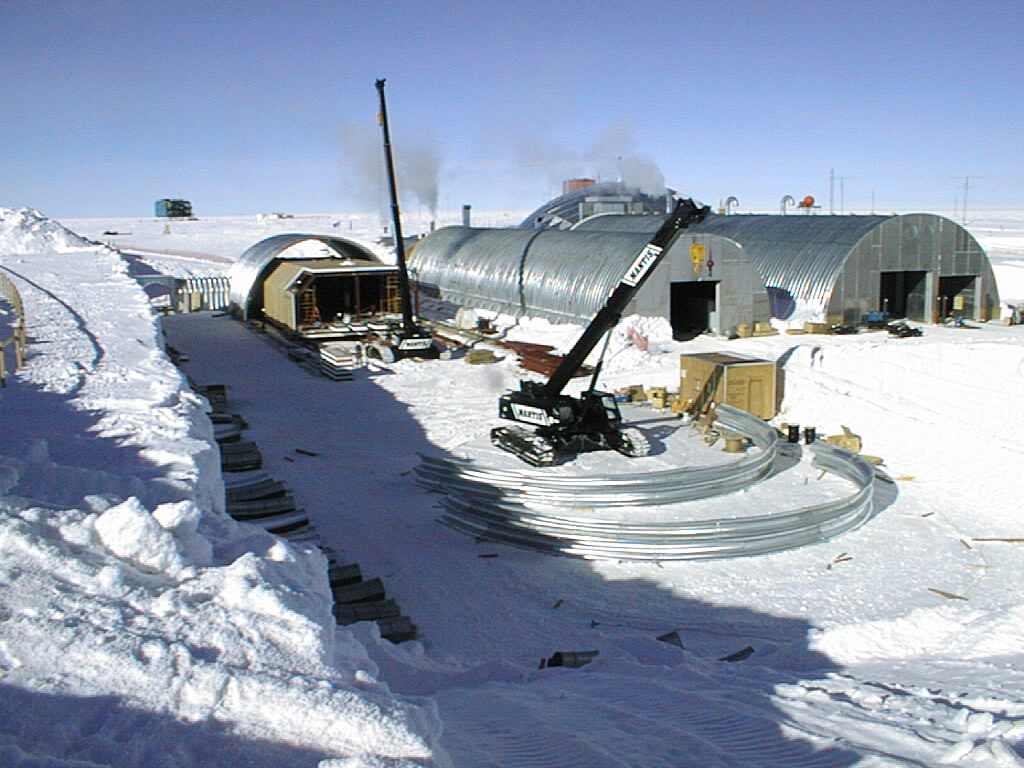

Demolition of the BIT is underway here, with the Mantis crane pulling stuff out of the inside. The radome has been removed--it was originally part of the original IGY station, and it is still sitting on the berm. Here is a detailed sequence of photos of the demolition!

This was followed by the cargo/helium arch, removed to make way for the new garage shop building

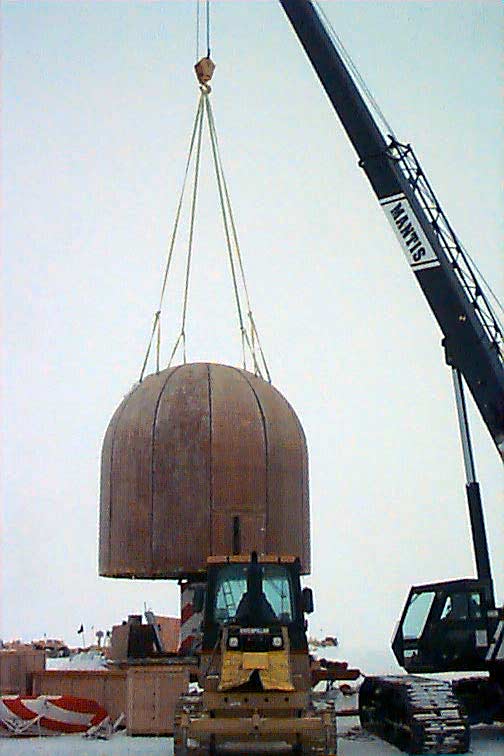

where'd the platinum in the hydrogen generator get to? The cargo arch was excavated and removed gently for possible future use...and some of it was. Seems that the new arches (garage and power plant) were designed to be aligned with the original garage arch, but it turned out that the old garage arch was one rib short. The rest of this arch is out on the far berm. That Russian air- plane that arrived in 2002 was parked next to it for a few years. All the photos are here.

Hose/cable connections to Rodwell relocated to clear footprint of new garage arch; the new routing blocks access to the snow melter, which was abandoned. A portable fuel-fired snow melter was obtained for use as a backup.

Visitors include Edmund Hillary along with the PM of New Zealand

New summer camp power plant completed with two 150kw 208v generator modules and an interconnecting module (one of these would later be moved to the dark sector and added to Building 61 substation there). The old 1981-82 camp power plant was demo'd and retrograded.

And...a new dome substation building was constructed to feed summer camp with 4160v power under normal conditions.

New NOAA building occupied, CAF is abandoned.

new clean air The newly completed Atmospheric Research Observatory (ARO) is shown here with the shipping crates for the instrumentation and other equip- ment that is being installed. None of the roof- mounted sample collection systems are in place yet. (NOAA CMDL/ESRL photo). This photo also happens to be the beginning of their virtual tour of the new facility.

3.2KW prototype wind turbine installed on 40' tower

wind it up

The Northern Power Systems (NPS) turbine project was begun in 1995, and the unit was installed at Pole in January 1997 for what turned out to be two winters of testing...with an estima- ted 10,000 hours of rotation.

A related project at the same time installed photovoltaic panels on the four sides of the roof of ARO (more pictures and information on these projects).

Winter 1997

Manager: Don McCreight, population 28

Digital all-sky camera in skylab replaces the 35mm model.

Major pipe freezing problems in the galley.

Congress approves full funding for the new station (the "South Pole Modernization Project," signed off on by President Clinton in November).

Summer 1997-98

CAF demolished, new NOAA building officially dedicated as the Atmospheric Research Observatory (ARO)

remains of the old Clean Air Facility
This large hole is where the CAF foundation used to be...all that is left is the top of that aluminum stairway that we installed to go down to grade in 1988. This is the only CAF demolition photo I've been able to find (Chris Rock). Meanwhile, the new ARO structure, which had been occupied during the 1996-97 summer, was officially dedicated on 12 January 1998 (Antarctic Sun article published on 28 January).

Summer camp moved east; the Jamesways are picked with the crane and moved in one piece. instead of dismantling/reassembly.

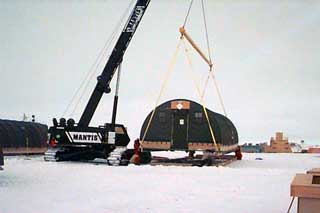

moving the summer camp The easy way to move a Jamesway nowadays since there is a crane available... Oh yes, if you haven't been inside one of these in awhile, keep in mind that there are permanent fire-resistant partitions and private rooms inside instead of those bunk beds with sleeping bags, No more Navy blankets hung up on ropes. No more Preways either, the forced-air furnaces are in separate structures to improve fire safety. (Chris Rock)

SPASE-1 boxes removed from in front of the fuel arch, they never detected cosmic gamma ray sources, the original goal...

Old Pole fuel recovery conducted to salvage 10,000 gallons of DFA for use by PICO...along with most of the old weather balloons.

Scott Smith at the bottom of the Holy Stairs

Plumber Scott Smith at the bottom of the main entrance during the multi-year investigation and recovery effort...here are more pages of photos and info....

GASP telescope shut down at the end of December and removed, replaced by VULCAN

Three NGA skydivers killed as they land with unopened parachutes (7 December)

photo at Pole just before the jump The group was sponsored by the same group that would later coordinate the "Millennium Expedition" with those snow buggies, more planned skydiving that didn't happen, and the balloon ascent that did. The photo at left is their "thumbs up" picture at Pole, after they'd set out the drop zone target and just before the event. Four of the six jumpers (in blue in the photo) planned a four-way jump starting with free fall...three of them hit the snow with unopened parachutes. With Polies watching (the story).

Three more AMANDA strings, this is start of "AMANDA 2"

New garage/shop arch erected.

new garage arch under construction

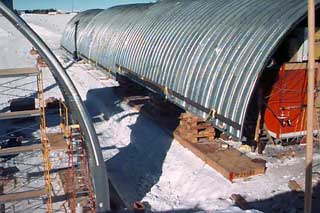

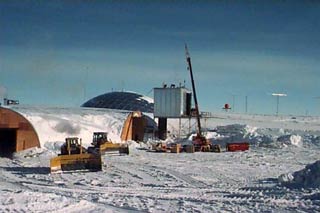

The new garage/shop arch under construction. The blue structure in the foreground is the cargo buil- ding; the red/white structure is part of the rodwell complex. (Chris Rock). Oh yes, many more photos are here.

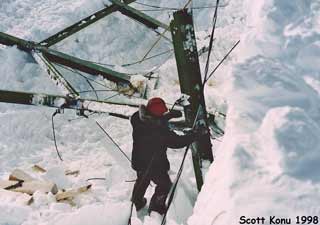

Existing garage arch dug out with the help of explosives, jacked 3' and erected on new kneewalls to match new garage arch elevation.

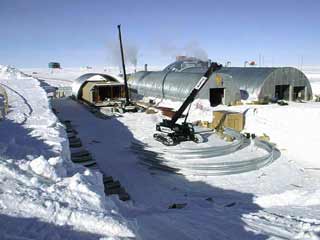

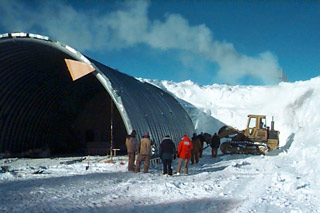

raising the old garage arch Explosives actually had to be used to break up some of the hardest ice, particularly for installation of the new footings. This photo shows the beginning of the jacking process, as well as the start of the new garage arch. Lots of photos (well, none showing the blasting) are here. The project also included interconnecting the two arches with corrugated steel passages. The new garage would be built starting in 1998-99; in 2008 the logistics facility would be built in the old garage arch.

VIPER equipment/telescope installed and put in service.

gape

Viper completed and mounted on the structure; this view is from behind MAPO (which is on your left) looking northeast. (CARA photo)

AASTO module installed successfully

GCA system replaced

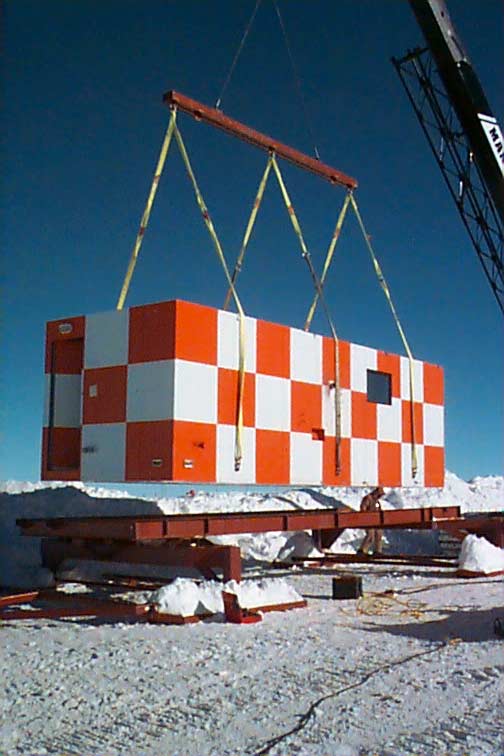

old GCA radomenew GCA/TACAN

Perhaps as a sign that the Naval Support Force Antarctica was leaving, the old system (left photo) was being replaced with the new up-to-date unit, which was on site until about 2007 when it was moved to the berm in deference to newer navigation systems. The old dome may be left over from the original IGY station. (Chris Rock)

SPTR (South Pole TDRSS Relay, the TDRS-1 satellite link) established

SPTR antennas atop the elevated dorm The original antennas were these mounted on the roof of what was then the elevated dorm, as seen here (later this building would be moved to become the IceCube laboratory). Seen here is comms guy Skip Withrow (photo by Kevin Culin). One of the el dorm rooms was devoted to the equipment (here's Andre Fortin working with it). The TDRS-1 satellite provided broadband comms and internet access, tested in December and declared operational on 5 January 1998, exceeding the initial design goals of 1.024 Mbps two-way access via S-band, and one-way data transfer of up to 50 Mbps on Ku band (these numbers were later improved upon). Here's an old NASA presentation on the project; here is another old information page which is also the source of these NASA photos.

Former astronaut Owen Garriott visits Pole and leaves his mark in Skylab (15 January)

Noel Garriott's autograph in the Skylab lounge

Garriott spent 60 days in space aboard NASA's SKYLAB III mission in 1973, as well as ten days aboard Spacelab-1 in 1983. He was visiting Pole as a member of a meteorite collection project--one of 3 such trips he'd make to the ice (2005 photo by Will Silva from the Antarctic Photo Library).

Here's a page of information and photos from a January 2000 visit to Pole by another meteorite collection team which included astronauts Owen Garriott and James Lovell (from Steven McLachlan's Antarctic philately web site).

Freshie shack enlarged

IRIS/USGS seismo equipment moved to UCLA "cold tunnel"

Treaty nations complete final ratification and approval of Madrid (Environmental) Protocol.

Winter 1998

Manager: Katy Jensen, population 28

NSFA (Naval Support Force Antarctica) leaves the ice for the last time and is disbanded.

Unique evening performance of short plays and monologues held (August)

South Pole play program

During the 2008 winter I spent a bunch of time cleaning, sorting, and reorganizing the quiet reading room. One evening I was quite surprised when this program fell out of a book! Looks like it was an interesting fun evening back in the days before Antarctic film festivals. I did some searches on the obscure works that were presented, and at least one of them was published and performed elsewhere.

If you are reading this site you will most certainly recognize many of the names of the performers :)

Next generation of videoconferencing--first MBone multicast video/audio presentation (4/1) as a part of "Live in Antarctica II" (this was not the first live video from the station, that happened during the 1994 winter.

Iridium satellite streaks show up in the sky amongst the auroras.

Summer 1998-99

Garage/shop building in new arch framed and enclosed (all the photos)

Cosray platform jacked 10'

Massive solar display of sun dogs/halos and refractions observed and photographed, probably a record event.

Old Pole salvage operations continue--heavy timbers removed for use in the new station construction.

Second Pole wedding happens (1 January)

cutting the wedding cake

The folks involved here were winterovers Roger and Donna Aldrich Hooker. The ceremony was conducted by Alaskan guy Ken Lobe. Here is a bit more documentation.

Chilean S-70 Blackhawk helicopter shows up (1/28) from Punta Arenas via Frei/ Carvajal/PH (news story)

Air Force LC-130 discovers a crevasse while taxiing for takeoff near Upstream D (81°S-140°W) 11/16--no injury or serious damage, but lots of work (Antarctic Sun story and more information and photos)

End of fuel arch dug out (a "slightly" bigger job than it was 10 years previously), bladders replaced with 45 10,000 gallon tanks with containment, a new pump station module installed. Also, new OSHA compliant escape towers installed on the sides and end of the arch...all this to remain as part of the new station

we used to dig this out with a D1

A view of the massive excavation required to expose the end of the fuel arch. The tanks are stacked in the arch in 9 groups of 5. (story and photos)

The Navy VXE-6 squadron makes its last flight to Pole, soon to be disestablished (the Navy is not completely out of the USAP program; they continue to manage the planning and design of major construction projects including the new station)

Winter 1999

Manager: Mike Masterman, population 41

...a new w/o record. The winter construction crew for the garage/shop building lives outside the dome in the elevated dorm.

First satellite phone call between South Pole and the North Pole.

New garage/shop building is finished out on schedule except that the paint went bad (!)

Local time was shifted from New Zealand time to the Denver time zone for the winter, to improve coordination with the ASA office (this experiment was never repeated).

The world and the news media focus in on the midwinter medical problems which bring on the first airdrop since 1995.

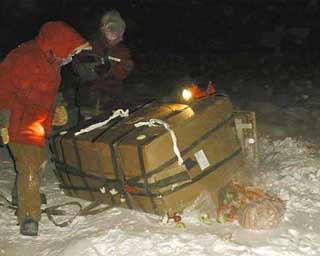

airdrop cargo

Harvesting the fruits (and vegetables) of the first airdrop since 1995 (Photo from Joel Michalski) (my coverage)

Power outage less than 24 hours before airdrop wipes out the last spare governor board, requiring some serious reverse engineering.

First USAF test flight of a C-17 aircraft into McM from ChCh (10/15), it has more than twice the load capacity as a C-141.

News media focuses on Pole again, the most coverage since Byrd flew over the place in 1929...

Summer 1999-2000

...as cancer patient Dr. Jerri Nielsen is evacuated on 10/16, the earliest first flight to Pole ever...(more information)

...and probably the first operational use of JATO for takeoff from the present skiway.

Taxiway reconfigured to make room for new station construction, not to mention that encroaching line of survey markers

New garage completed and occupied

car park #2

The interior of the new garage, heavy shop, vehicle maintenance facility, or whatever... It was officially completed and occupied in December. It is 5 times larger than the original garage, which wasn't demo'd for a few more years. Here's the rest of the story, photos and info.

Margaret Lanyon, NSF representative in ChCh, retires after 36 years.

Art Mortvedt lands historic Cessna 185 "Polar Pumpkin" at Pole (22 November)

Mortveldt at Pole Not the first single-engine aircraft at Pole, but more recently this one has generated additional interest. An Alaska bush pilot, Art worked for ANI for multiple years, and also flew for Delta. This aircraft was owned by ANI at the time and had previously been flown by Giles Kershaw. When ANI decided to get rid of this single-engine aircraft, Art purchased it. In 2011 he was en route to the North Pole, to make this the first aircraft to land at both poles...that attempt was unsuccessful, as was his 2012 try. But on 6 April 2013 he finally succeeded...after which he spent the night at Barneo before heading back south.

Construction of new power plant arch and structure underway in front of old garage arch

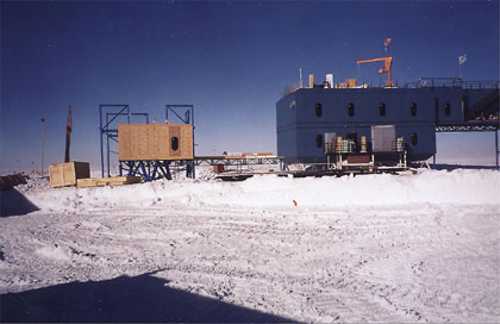

new power plant under construction

The new power plant structure is being erected at the same time as the arch...to the right is the "original" garage arch which has been elevated on new kneewalls, and to the right of it is the new garage arch, containing the garage/shop structure officially completed in December 1999. Here is the large version of this picture...(photo by Brad Halter)

SPIREX infrared telescope shut down and removed; DASI, the next CMBR detector installed in its place

Exterior shell of new Dark Sector Lab constructed.

DSL under construction DSL would drop in priority and wouldn't be framed out until 2002-03. Still unoccupied in 2004, it was designated as the replacement structure for most of the skylab science, as well the future 8m telescope, which turned into a 10m telescope. Here are the construction photos as well as more information.

"Millennium" live TV coverage features the annual relocation of the Pole, NOAA balloon launch, and the New Years party.

"Russian Millennium Expedition" arrives at Pole a few days after 1/1; the longest rubber-tired vehicle traverse in history shows up and launches the first hot- air balloon!

ouchup up and away

At left, one of the 6x6 gasoline-powered "snow bugs" demonstrates its extreme low ground pressure by driving over some of the Polies; at right is the historic balloon flight (photos by Robert Thompson); (my page with more details and links).

7-person Argentine team arrives unannounced from Belgrano on snow machines for official visit (1/4-1/7)

New toilet facility in upper galley (bar) completed, replacing hot-water urinal in fan room.

Six more AMANDA strings drilled and put in service.

Tunneling begins for main water/sewer system for new station--first of 3 years of work for the CRREL machine. Project led by tunneler John Wright

Unheated hypertat walkway built to facilitate winter berthing use

continue to winter 2000...
